SR-656/17th Street East End of Bridge Rehabilitation and Improvements Project

Financial Number: 446106-2-52-01

Project Length: 4,730.5 Feet / 0.90 Miles

Project Limits:
From the west side to the east side of the SR-656/17th Street bridge

Virtual Public Meeting:

Start Date: September 5, 2023

Completion Date: Summer 2028

Contractor: Vecellio & Grogan, Inc.

Estimated Construction Cost: $22.3 million

Scope of Work: The project improvements consist of replacement of the eastern 400 feet of the existing bridge; sealing the full length of the existing bridge deck surface; and upgrading signing and pavement markings.

Point of Contact:

Para información y preguntas en Español, por favor llame al (954) 777-4302.

Documents:

PDF Icon17th Street Bridge Project Update January 2024

PDF IconVPM 17th Street Bridge

Click here for upcoming lane closures

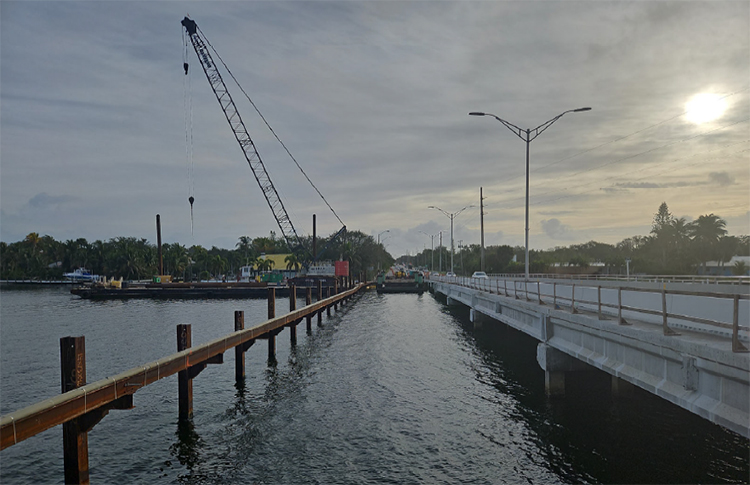

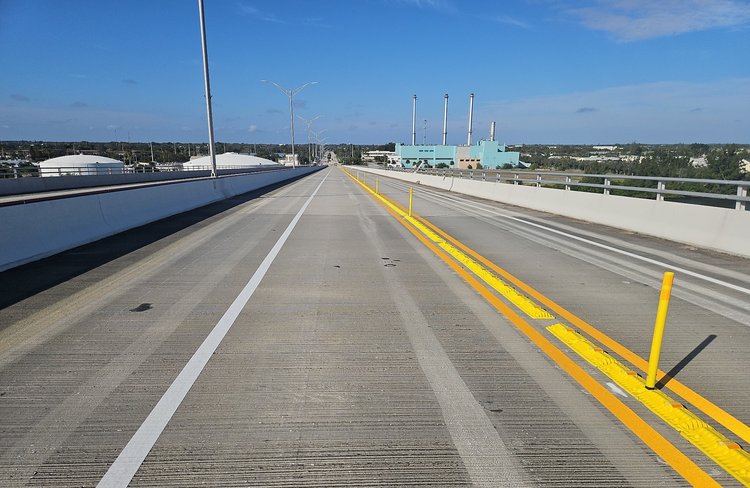

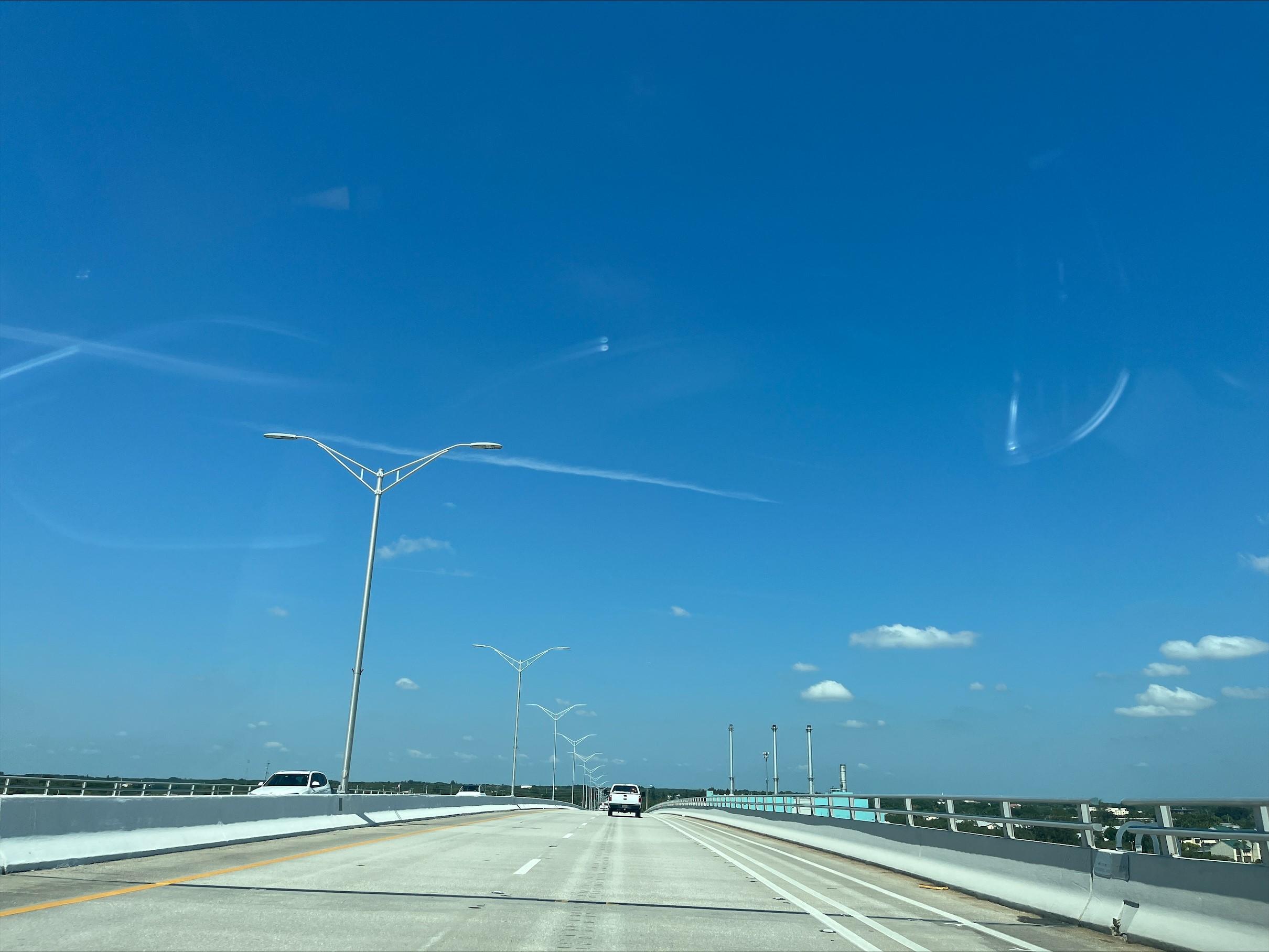

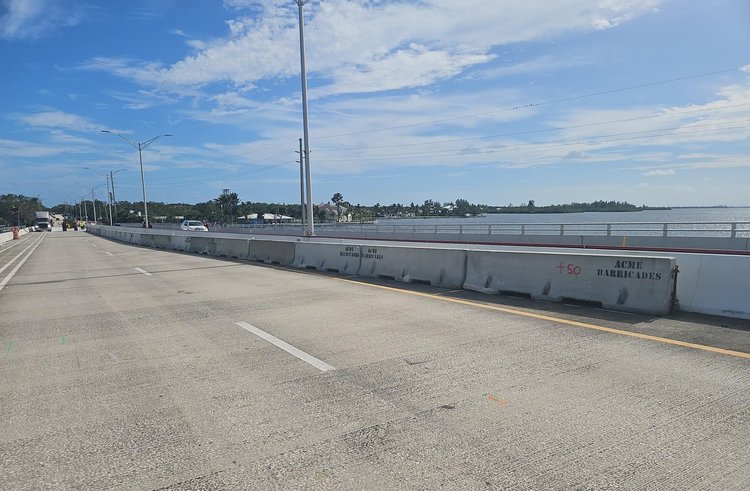

Pre-Construction

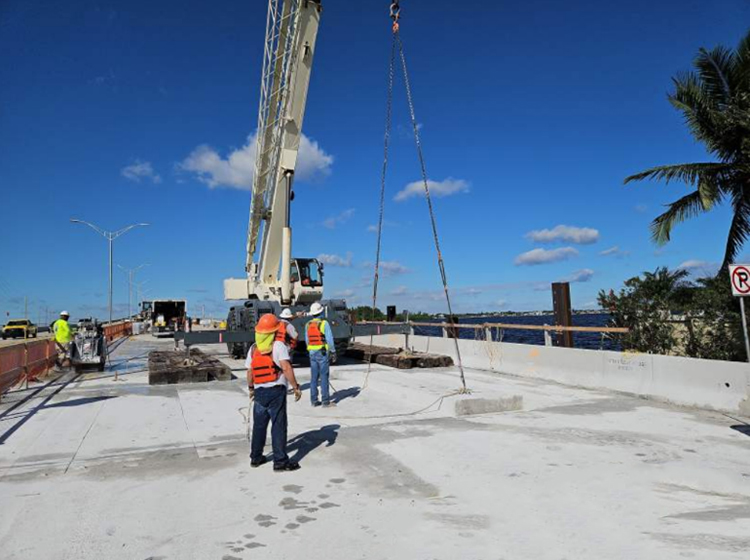

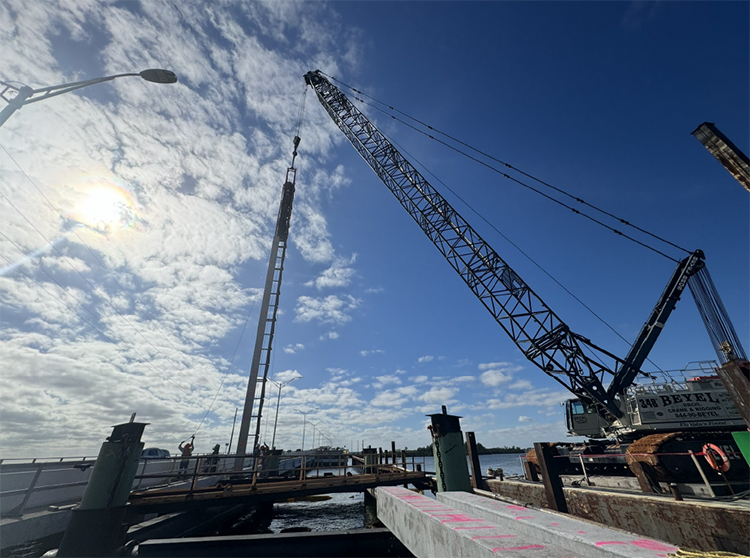

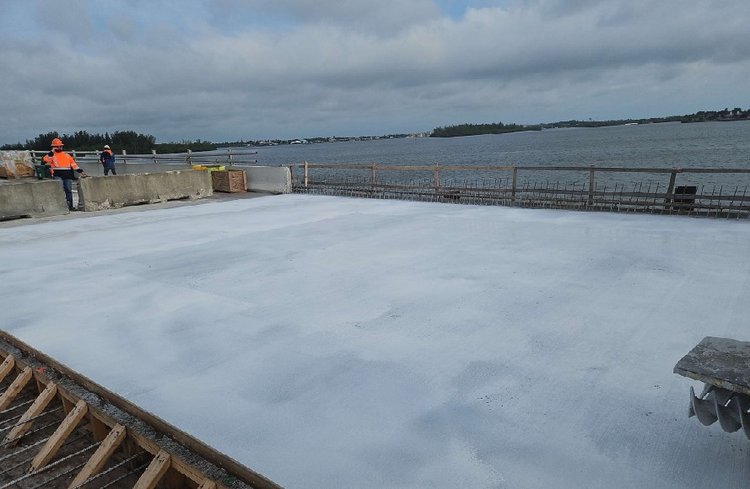

Click to view enlarged version/details

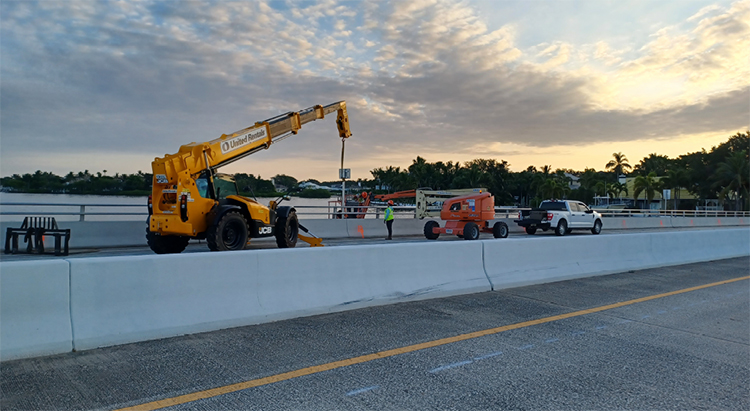

During construction During construction During construction During construction

During Construction

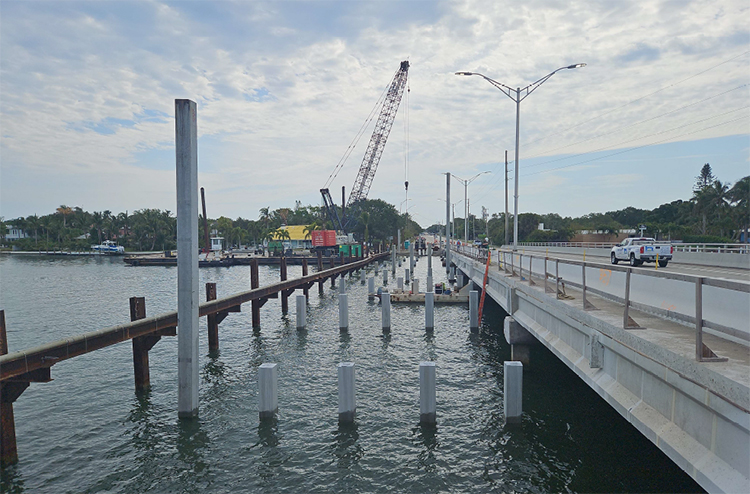

Click to view enlarged version/details
During construction During construction During construction During construction
During construction During construction During construction During construction
During construction During construction

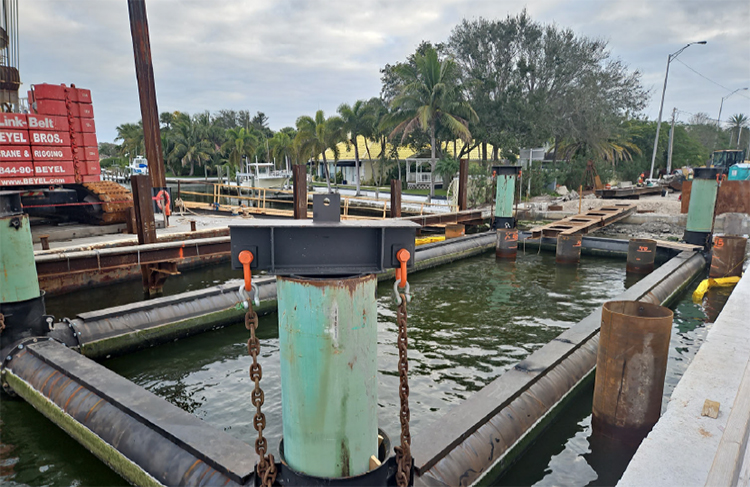

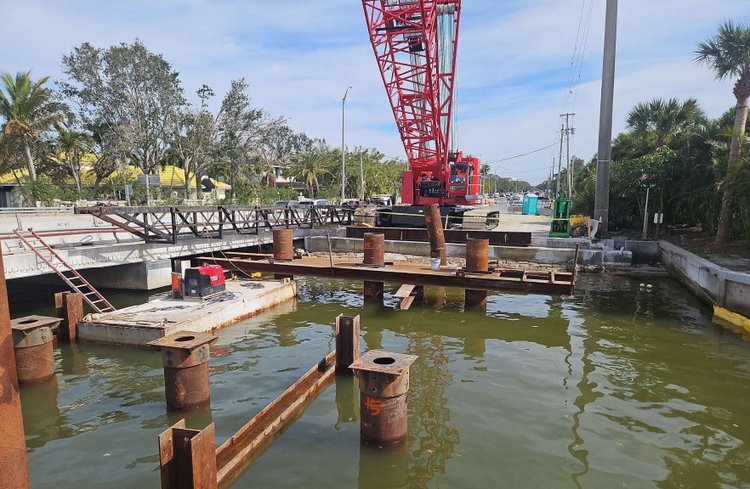

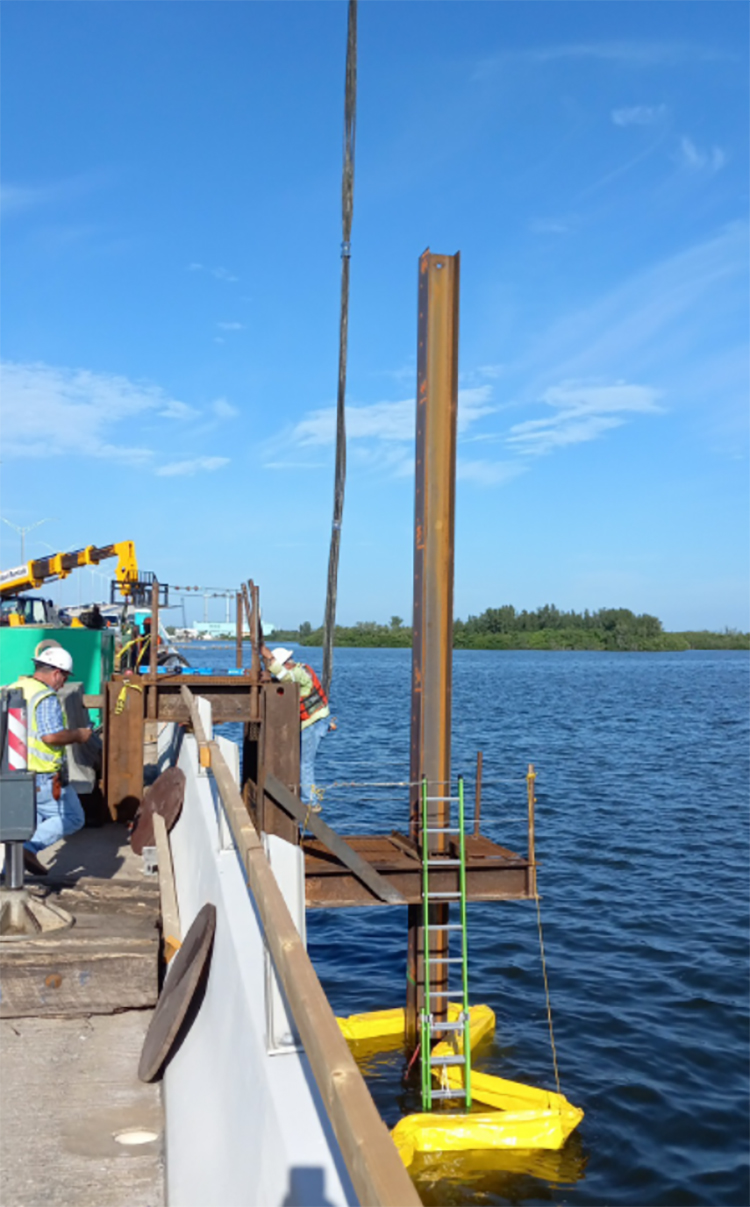

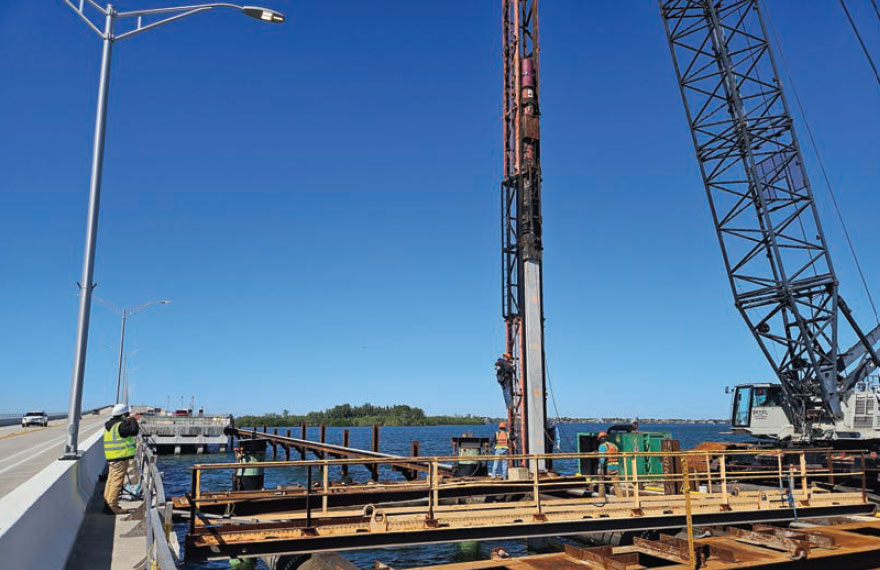

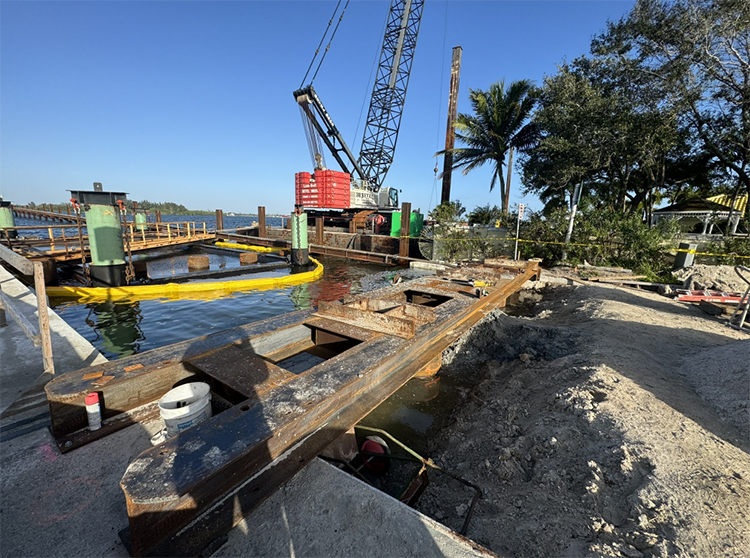

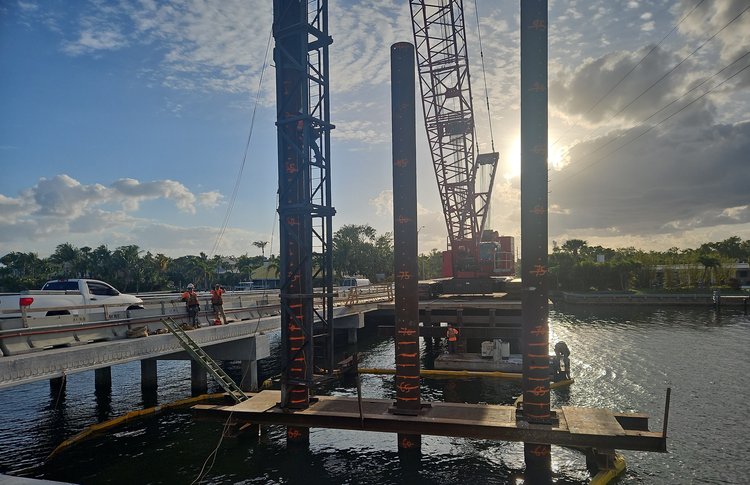

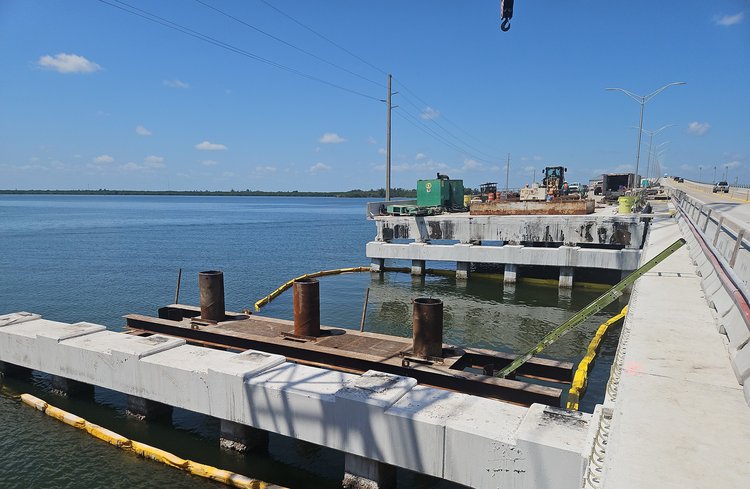

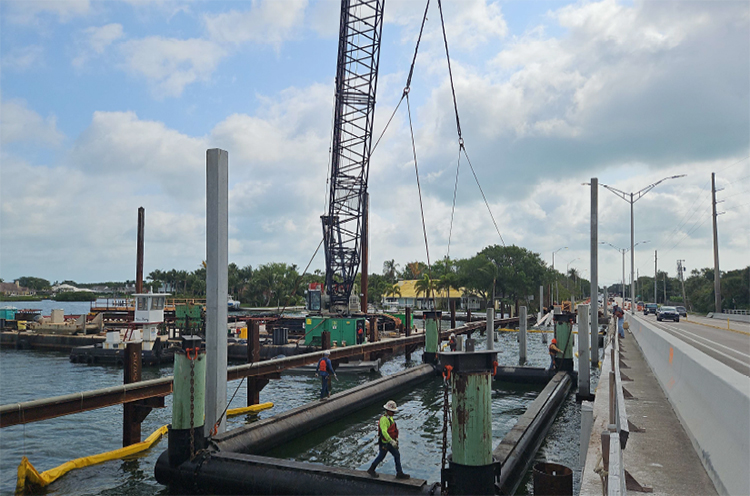

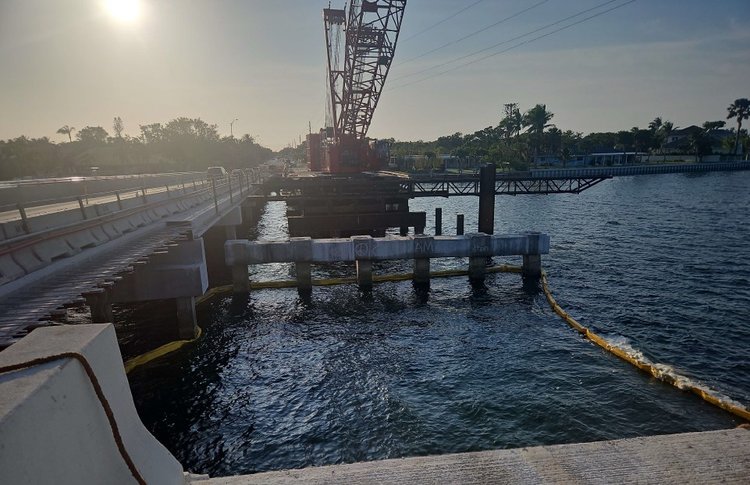

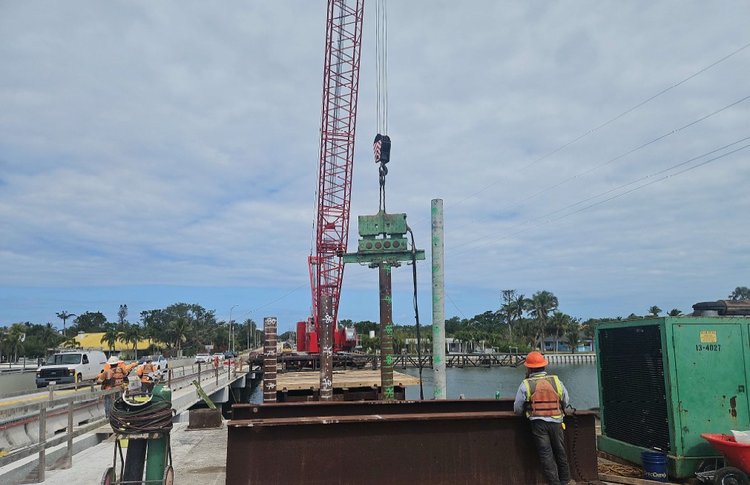

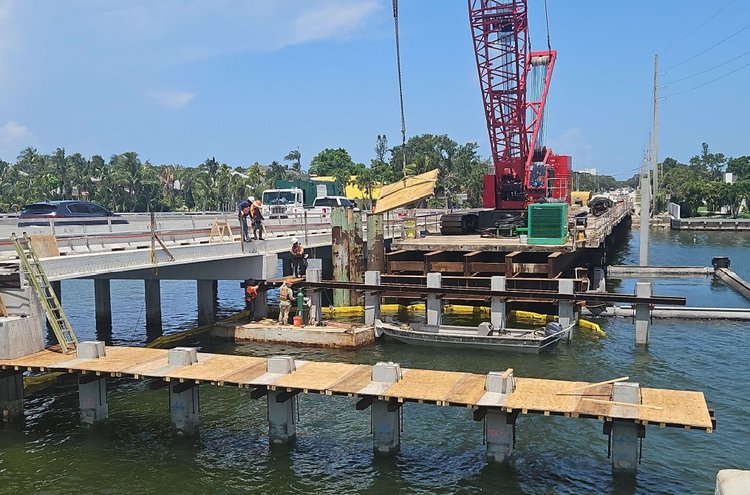

Driving of production piling completed at Bent 64, Mar. 2024 Testpile at Bent 59, Mar. 2024

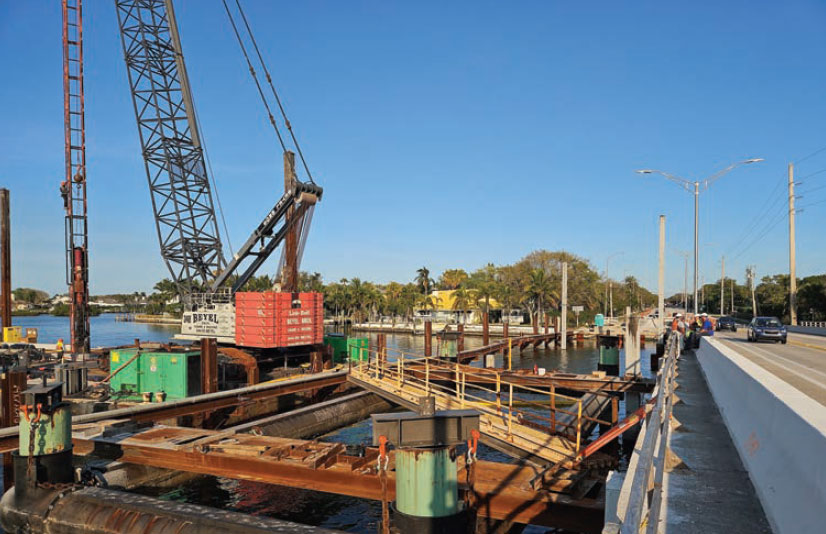

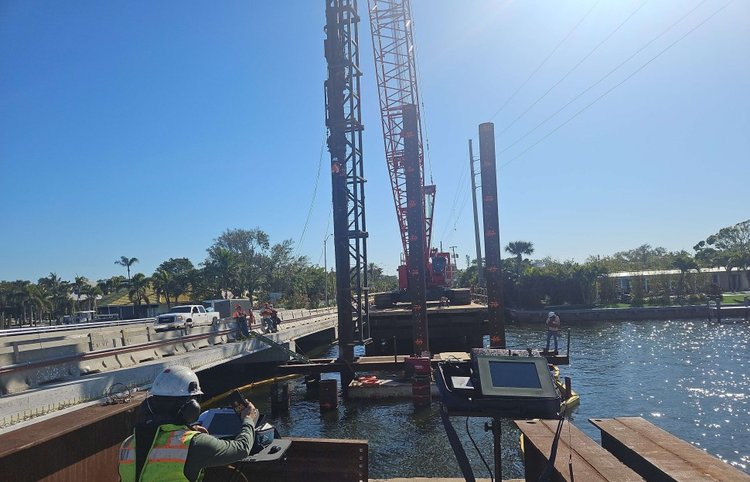

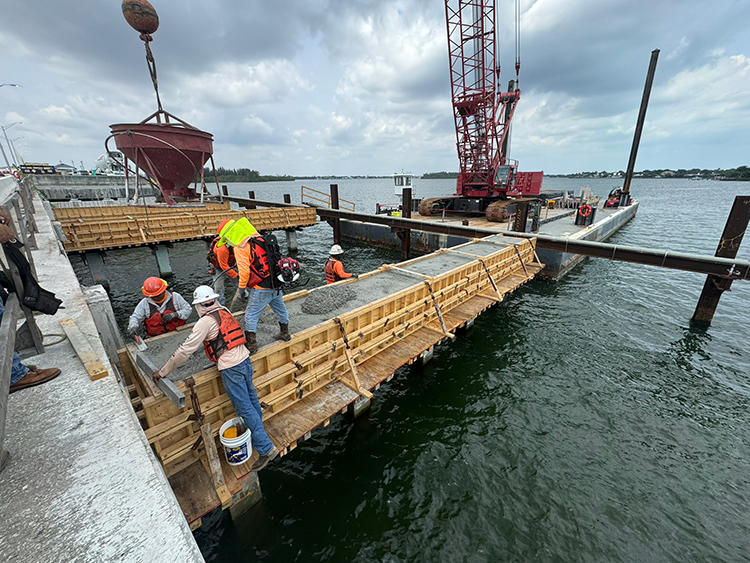

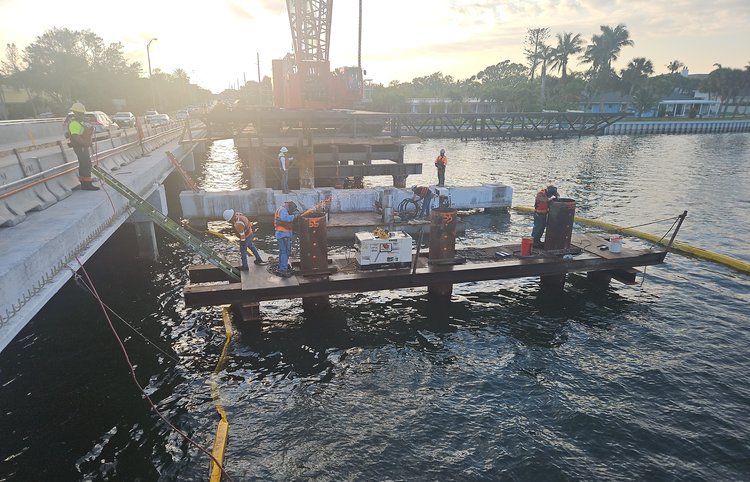

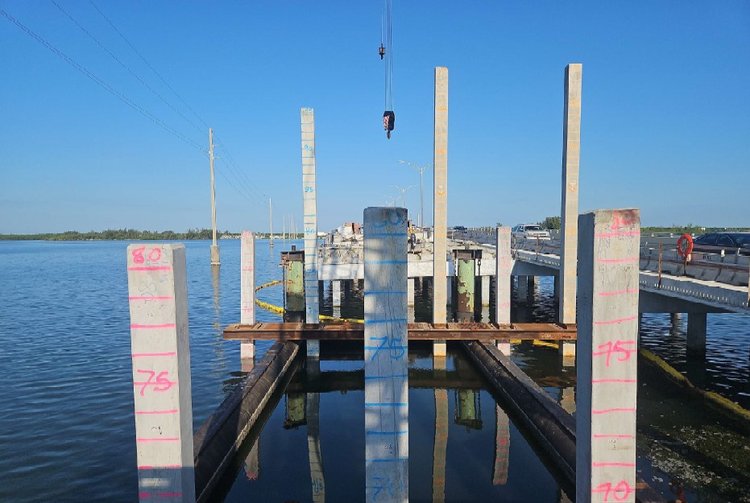

Relocation of floating pile template, Mar. 2024 Backfilling of casings with sand, Mar. 2024 Performing for Piling installation, Apr. 2024 Receiving Piling Materials, Apr. 2024

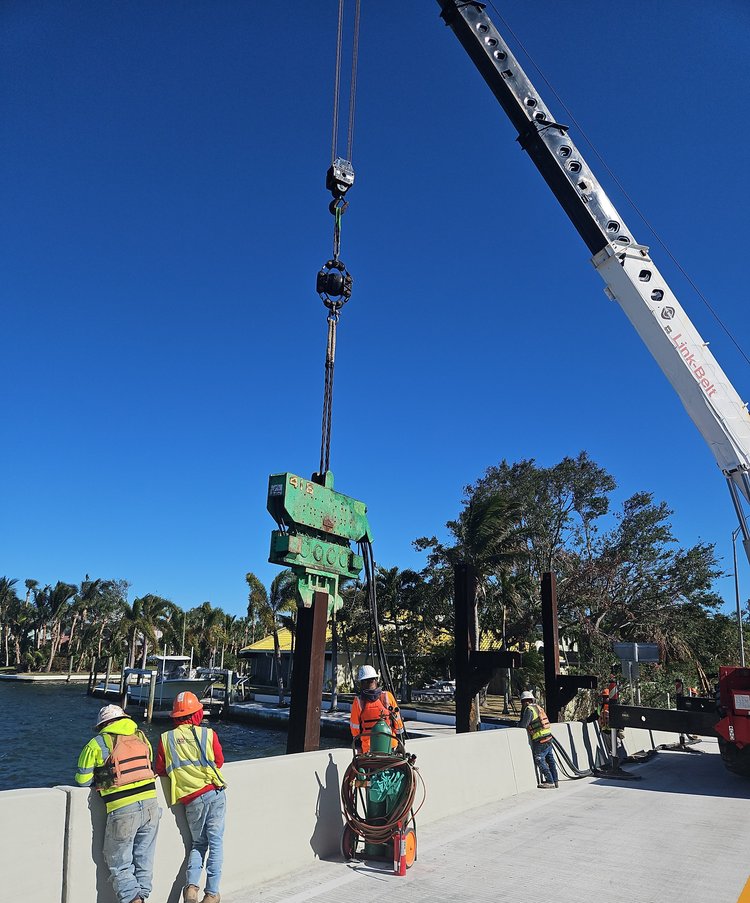

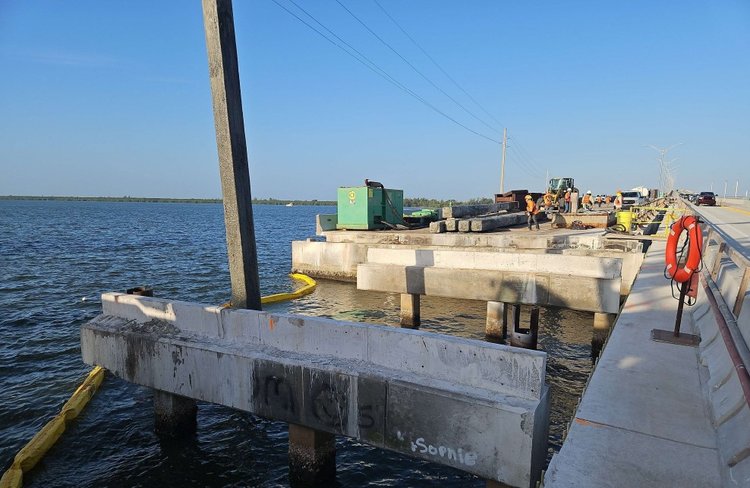

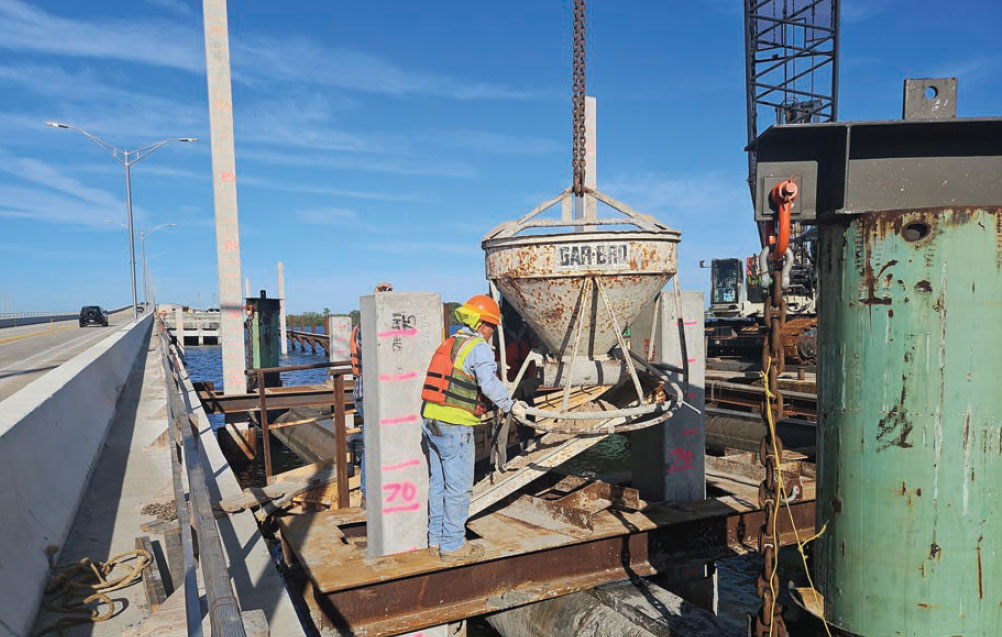

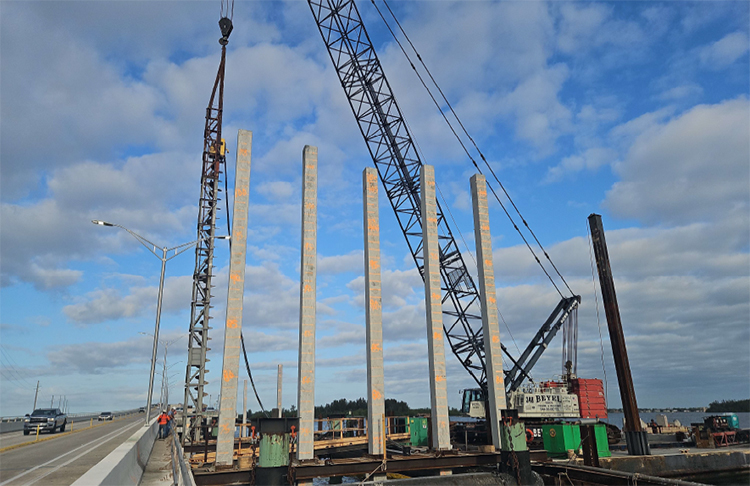

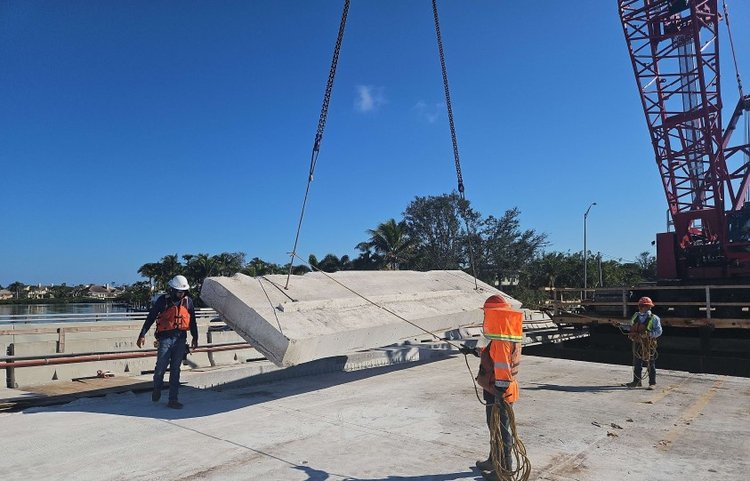

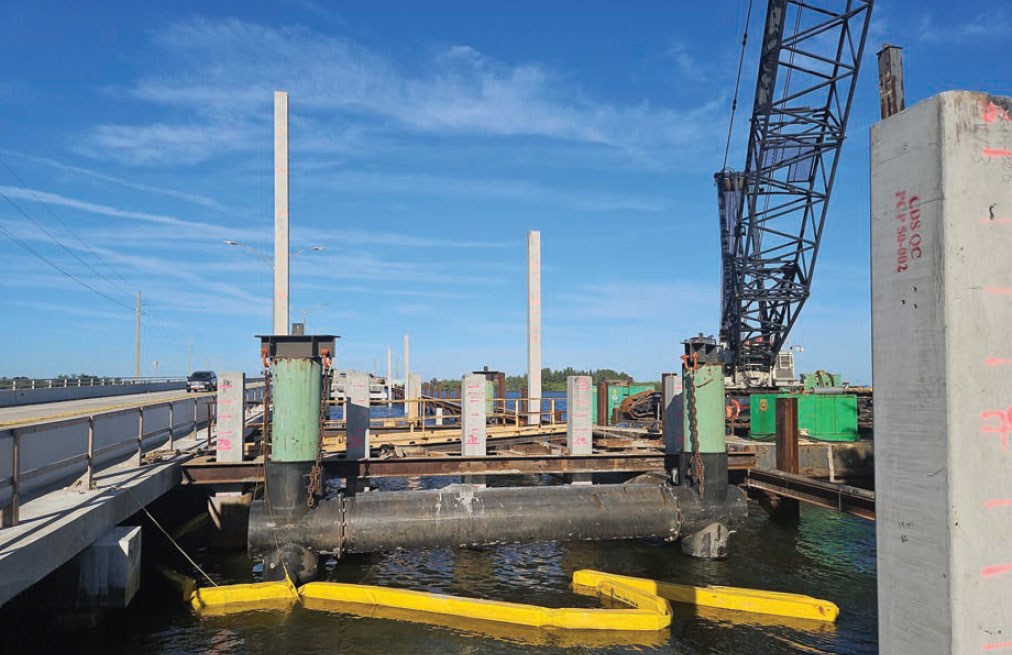

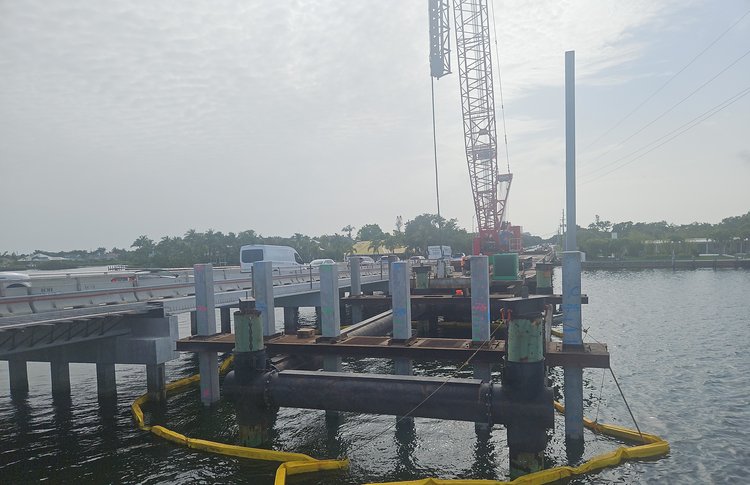

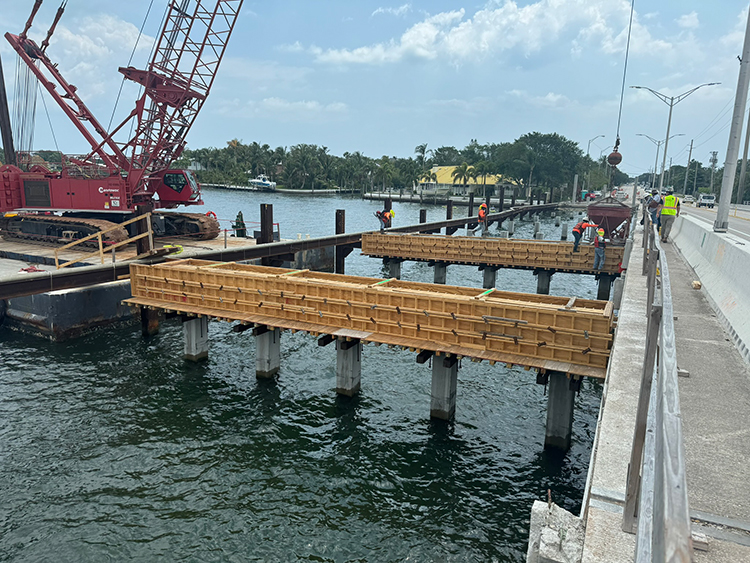

Phase I piling installation completed, Apr. 2024 Relocation of piling template, Apr. 2024 Placing concrete phase 1 bent cap 59, May 2024 Installing Pile formwork hangers, May 2024

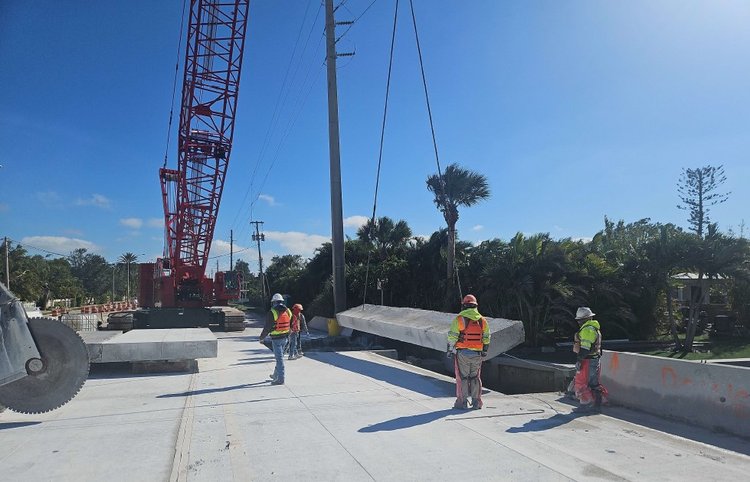

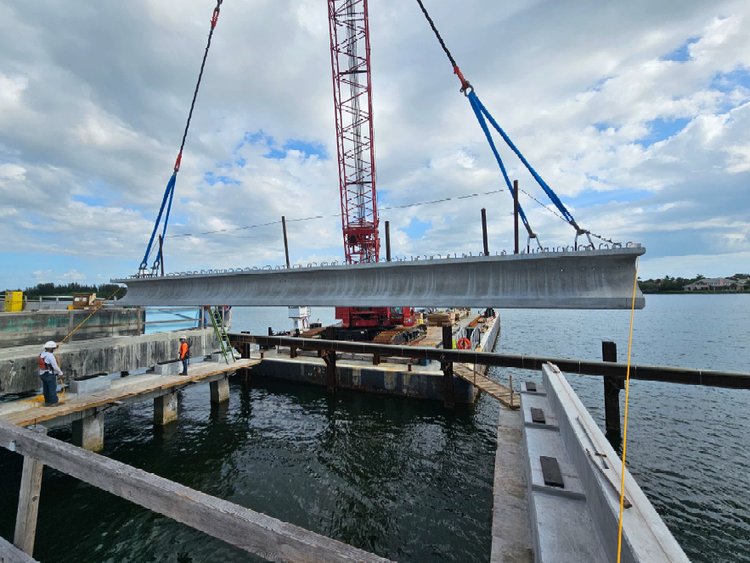

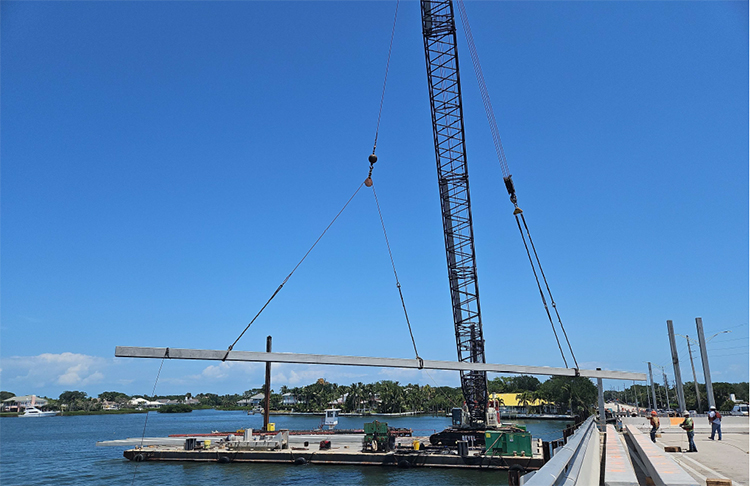

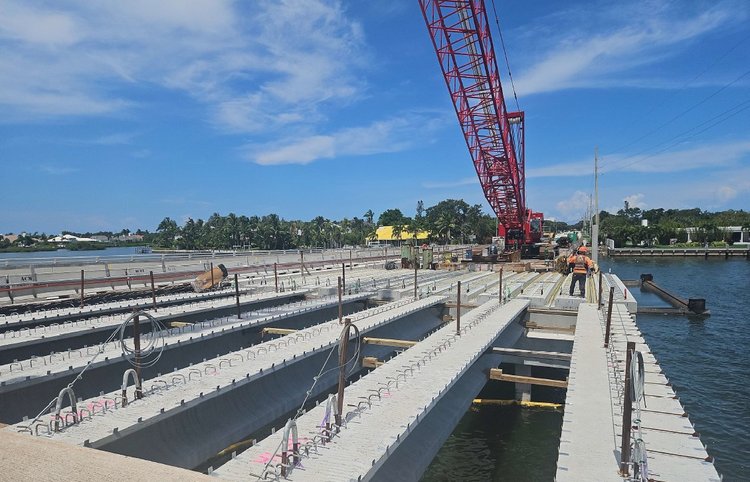

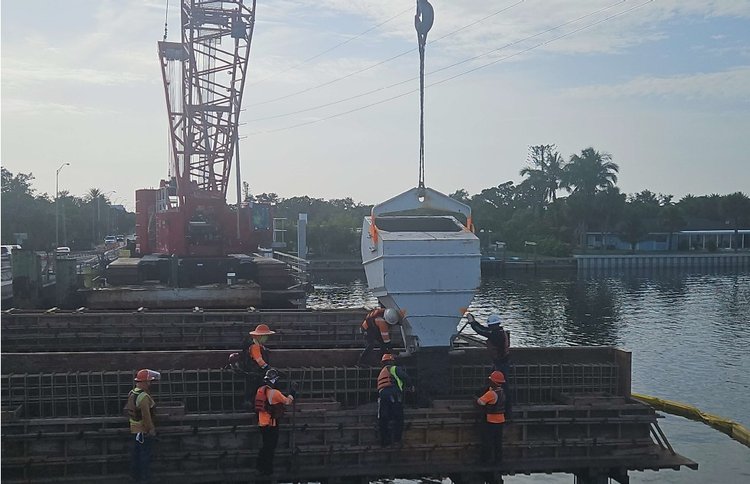

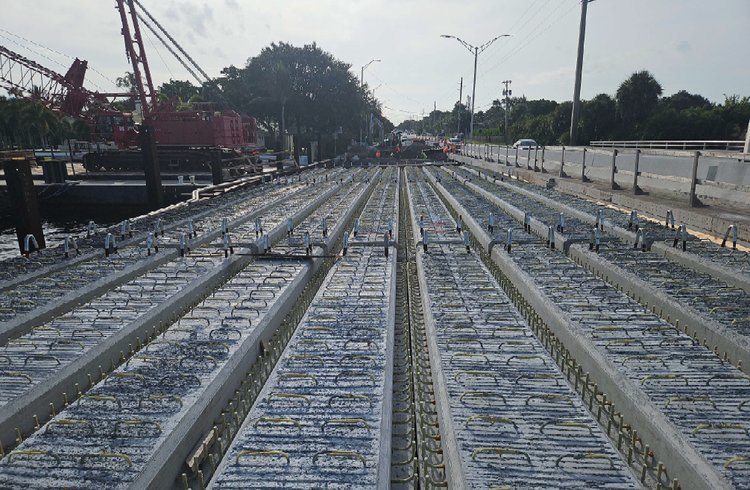

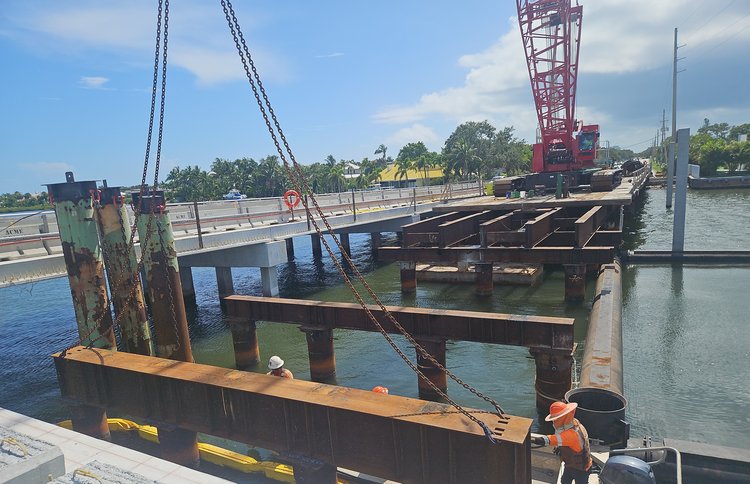

Placing concrete phase 1 bent cap 59, May, 2024 Setting beams span 56, July 2024 FIBs set span 56, FSBs set spans 57 60, July 2024 End bent 65 placed and cured, July 2024

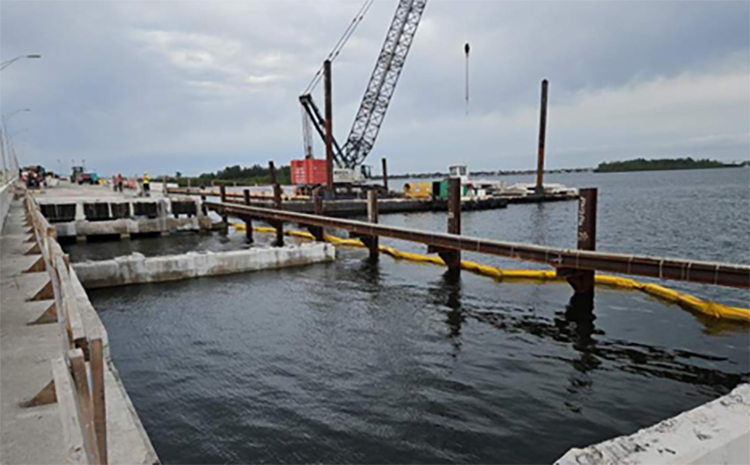

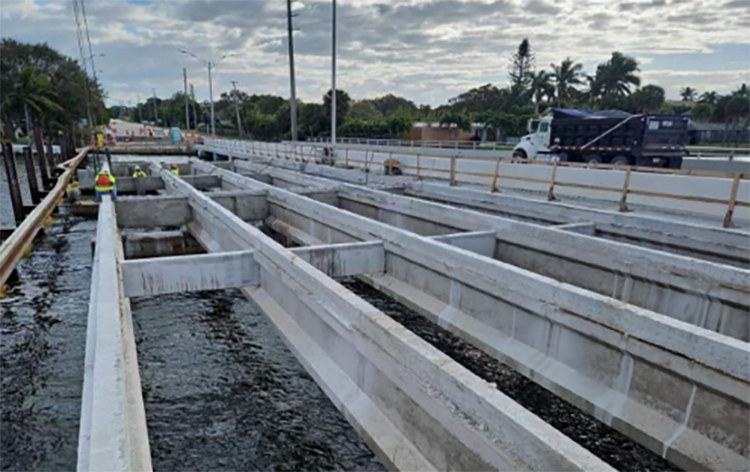

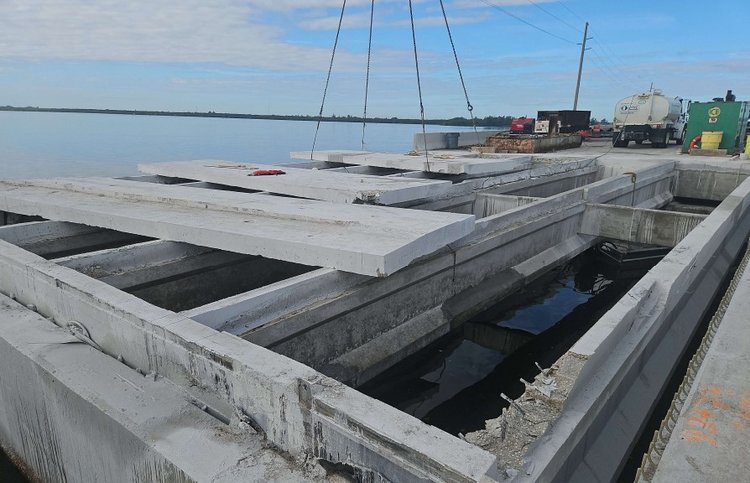

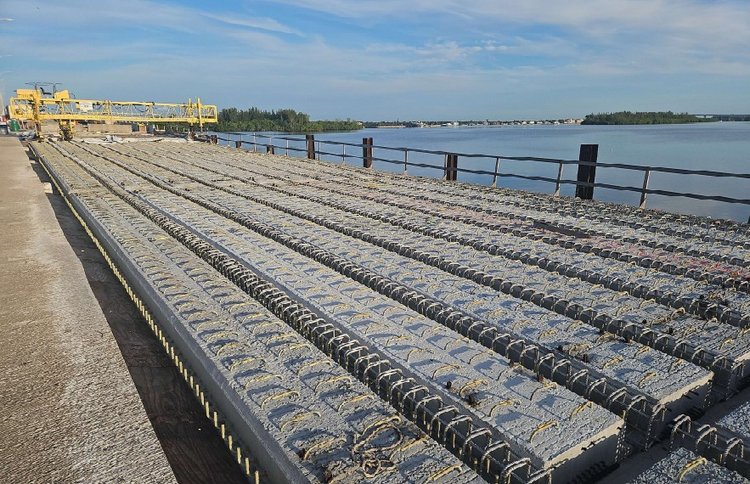

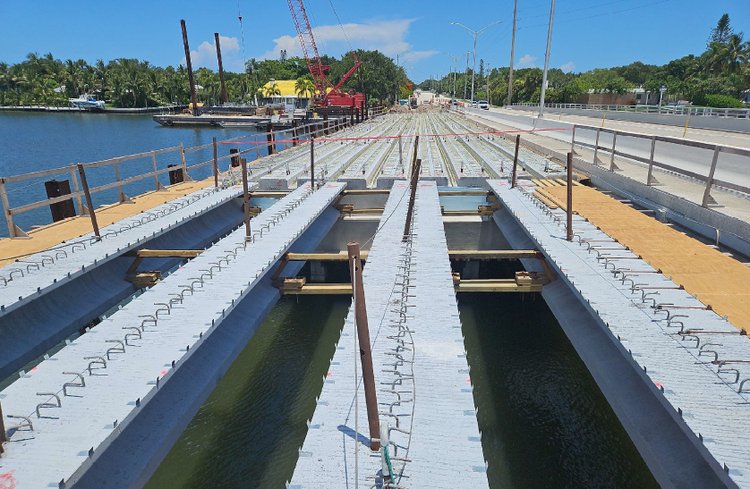

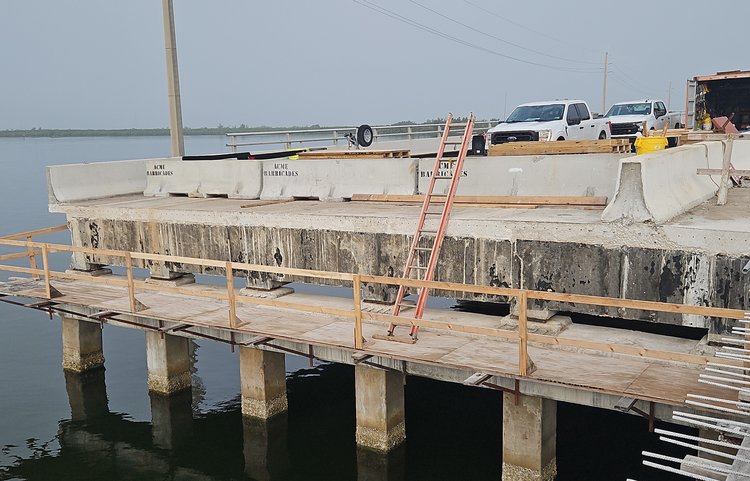

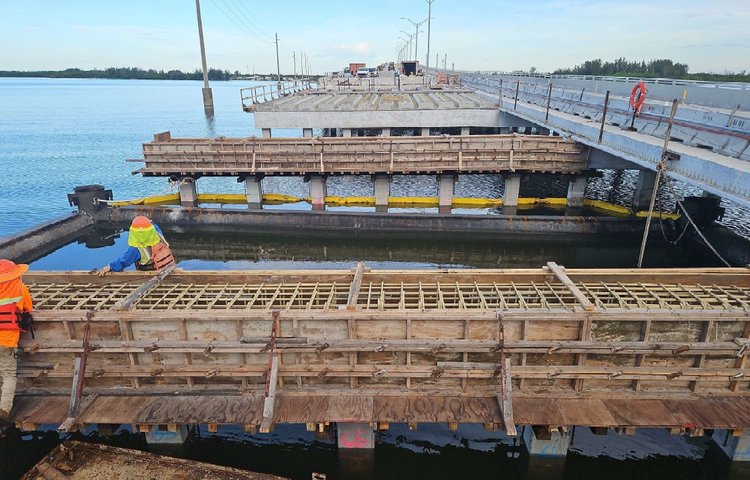

Phase I FSB slabs in place for spans 60 62, July 2024 Reinforcing stirrups tied and installed for Phase I FSB spans 57 60, Aug. 2024 Concrete placed and curing Phase I Span 56, Aug. 2024 Deck phase 1 prepared for barrier wall installation, Oct. 2024

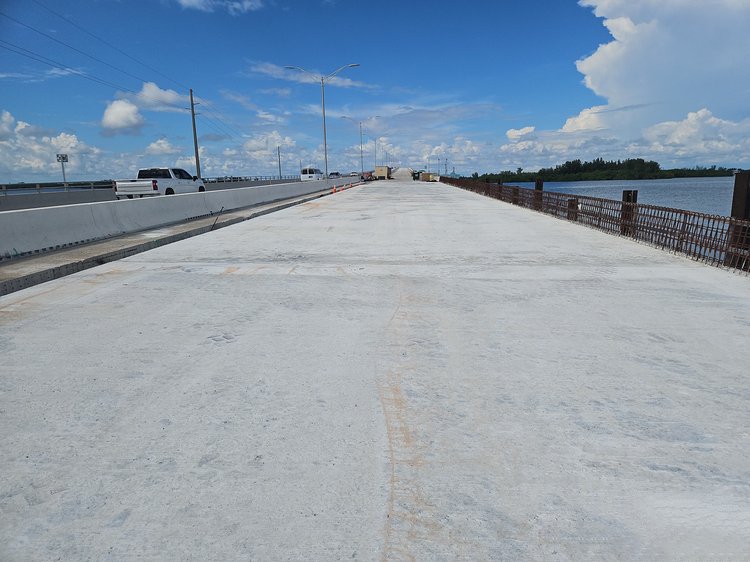

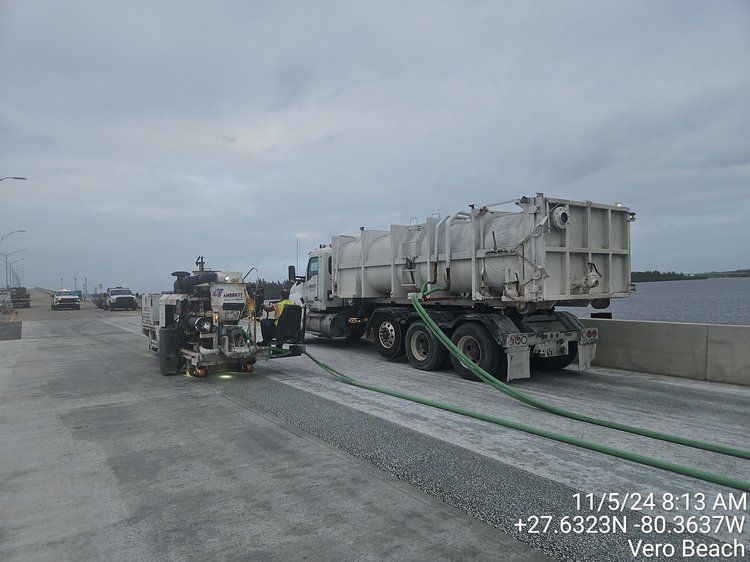

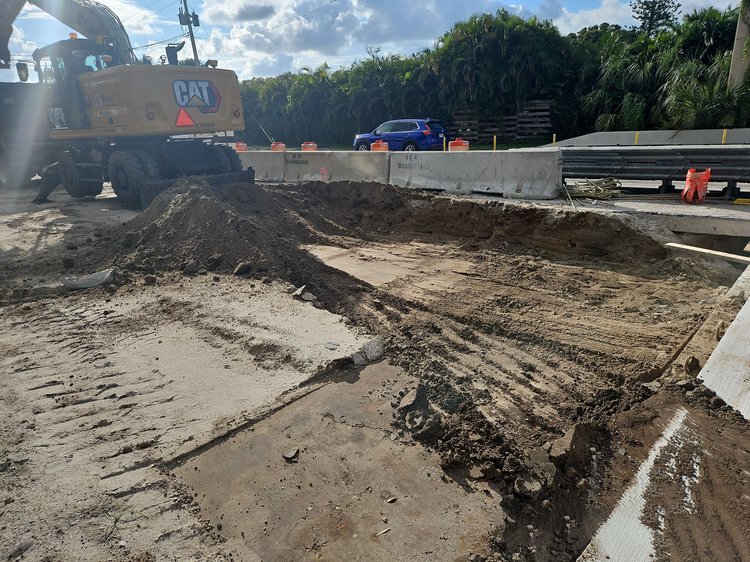

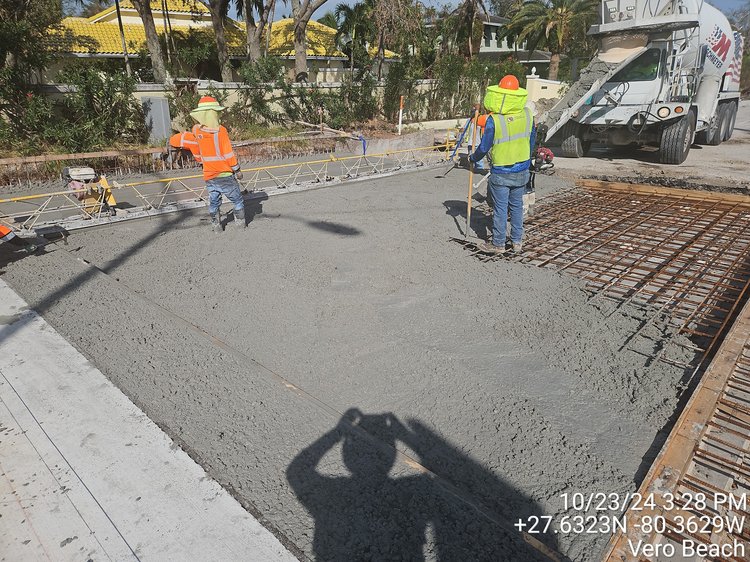

Excavation for the subgrade and base for approach slab phase 1, Oct. 2024 Setting type K barrier wall preparing for Phase 2 MOT transition, Nov. 2024 Planning the Phase 1 deck riding surface, Nov. 2024 Placing concrete Phase 1 approach slab, Nov. 2024

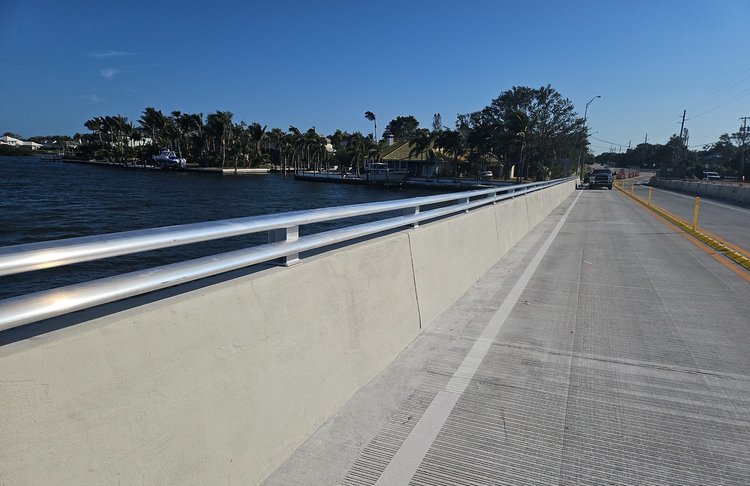

Phase II Lane Separator and Temporary Striping Installation, Dec. 2024 Relocation of Phase I Utilities Back to the Reconstructed Bridge, Dec. 2024 Instalation of Phase I Aluminim Bullet Rail, Dec. 2024 Removal of Phase I Temporary Utility Support Piling, Dec. 2024

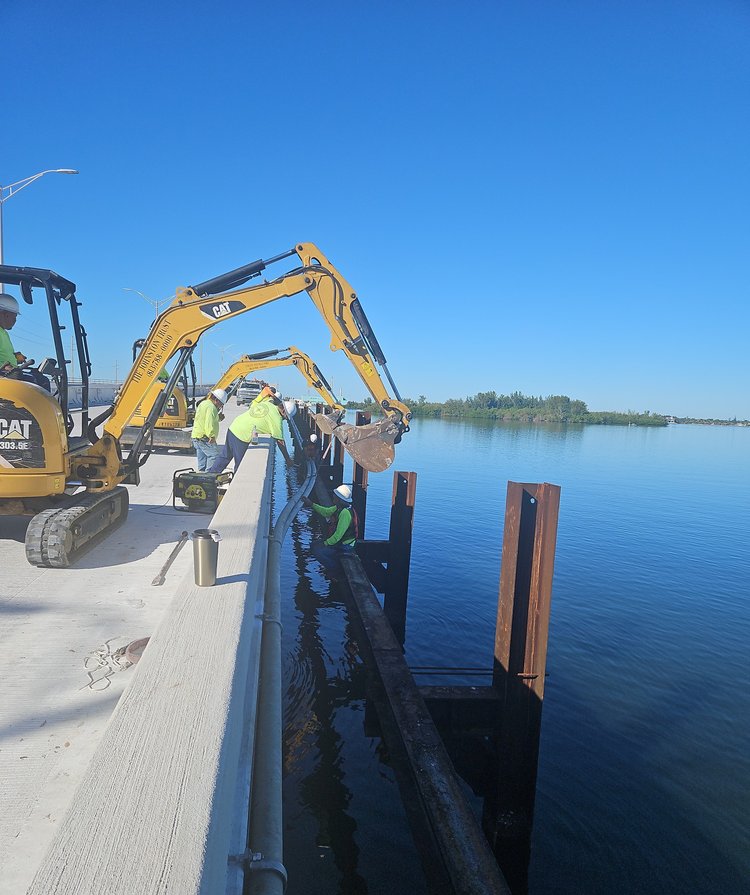

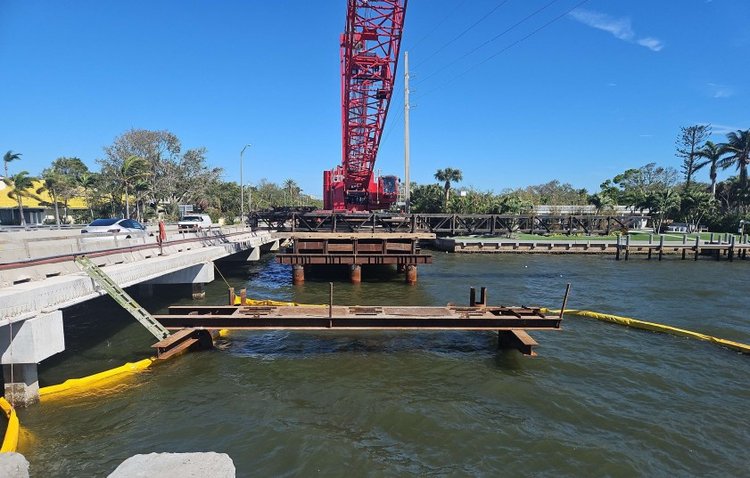

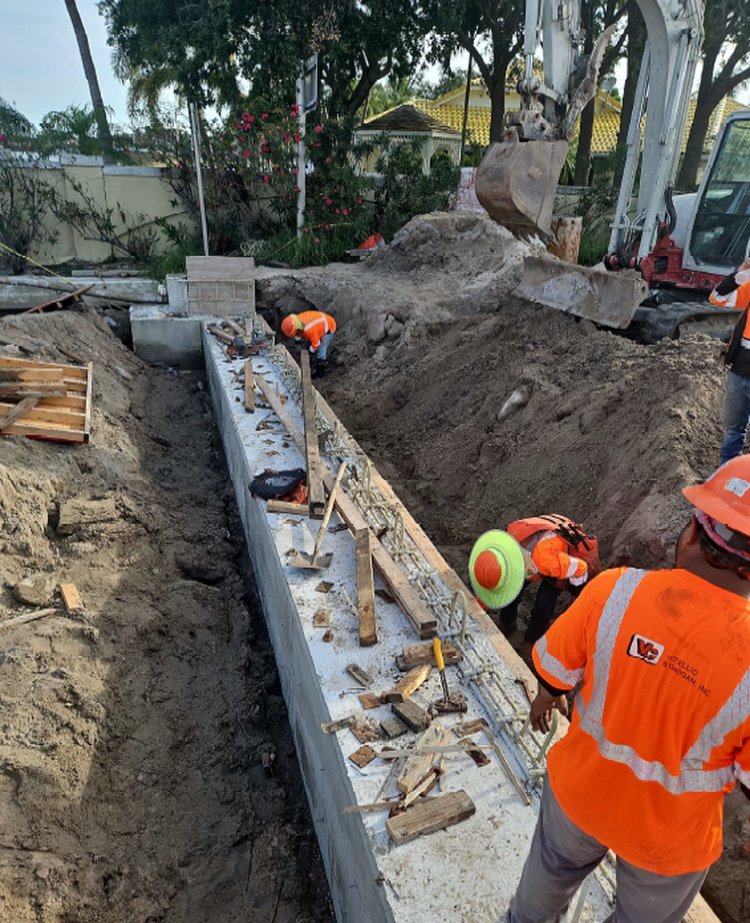

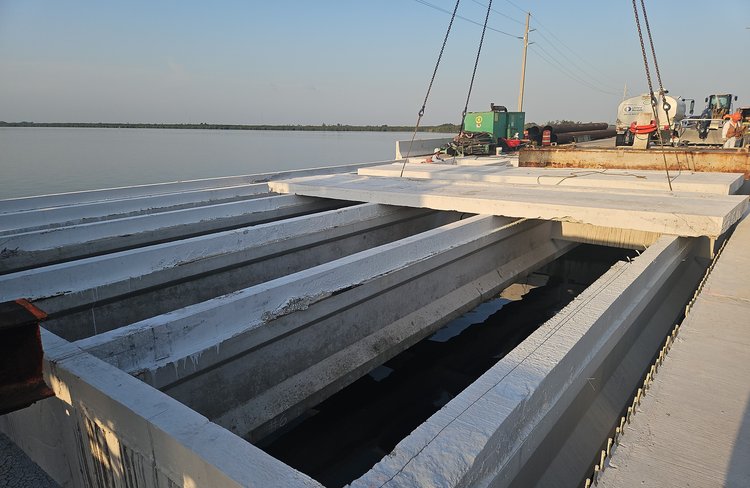

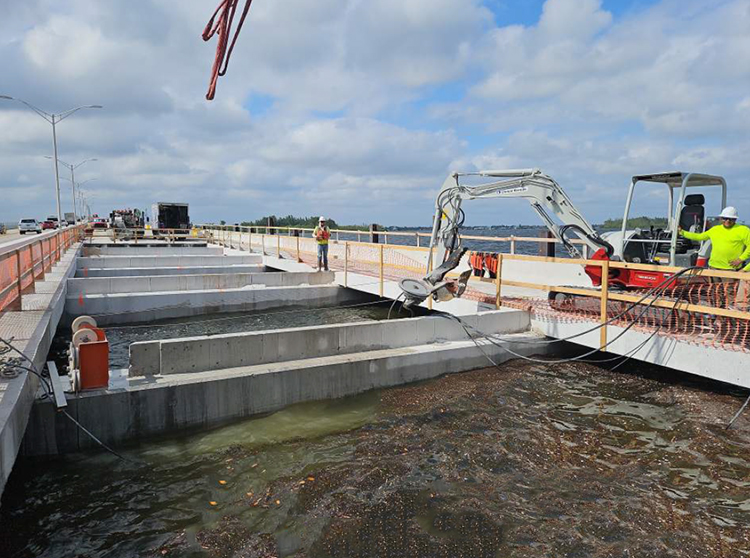

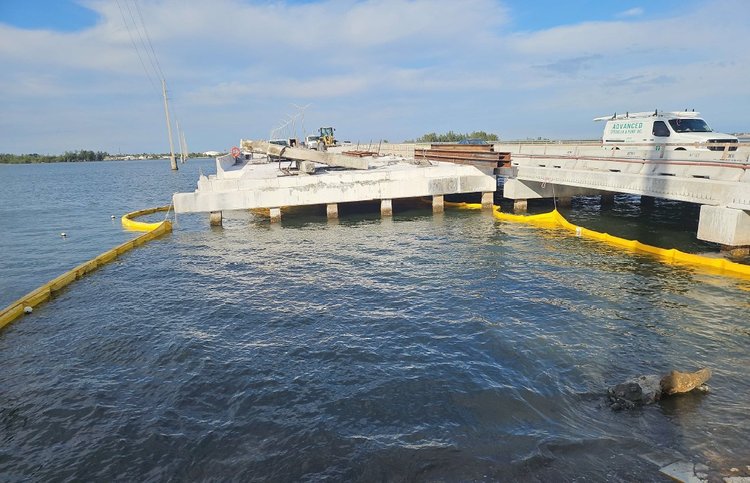

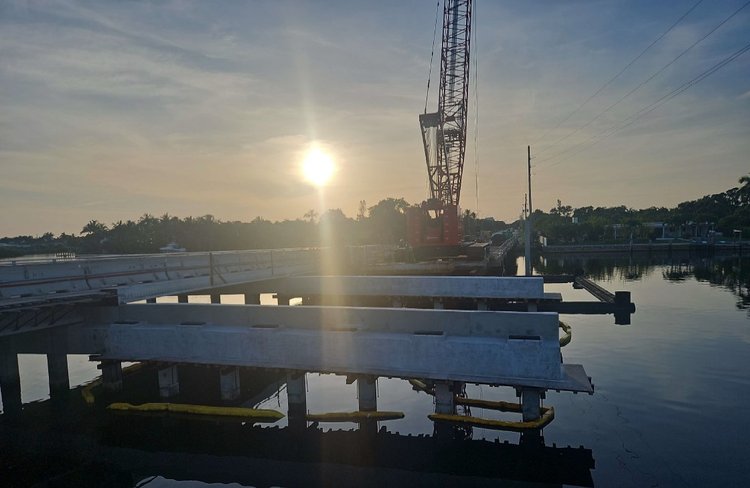

Phase 2 demolition deck span 63, Jan. 2025 Phase 2 substructure demolition spans 62 64, Jan. 2025 Demolition deck span 62, Feb. 2025 Construction of temporary work platform, Feb. 2025

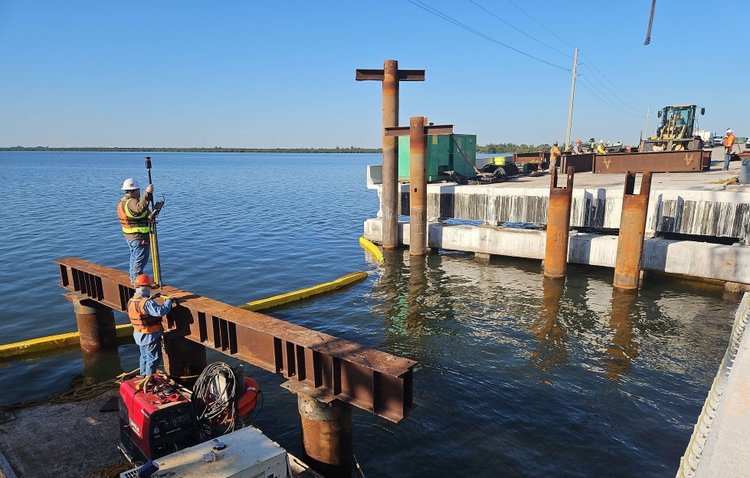

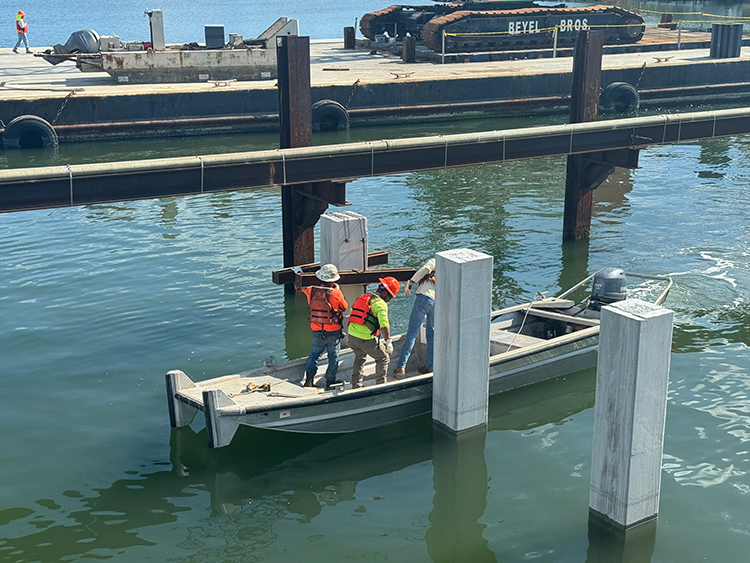

Substructure caps and piles of bent 61 and 62, Feb. 2025 Trestle pile template for trestle bent 5 and 6, March 2025 Surveying of trestle bent 6, March 2025 Pile driving analysis of trestle pile bent 5 and 6, March 2025
Demolition of existing deck span 59, March 2025 Phase 2 temporary work platform driven bent 8, span 58 demolished, bent pending demolition, April 2025Phase 2 pile driving of temporary work platform pile bent 7 and 8, April 2025Phase 2 pile splicing for temporary work platform bent 7 and 8, April 2025

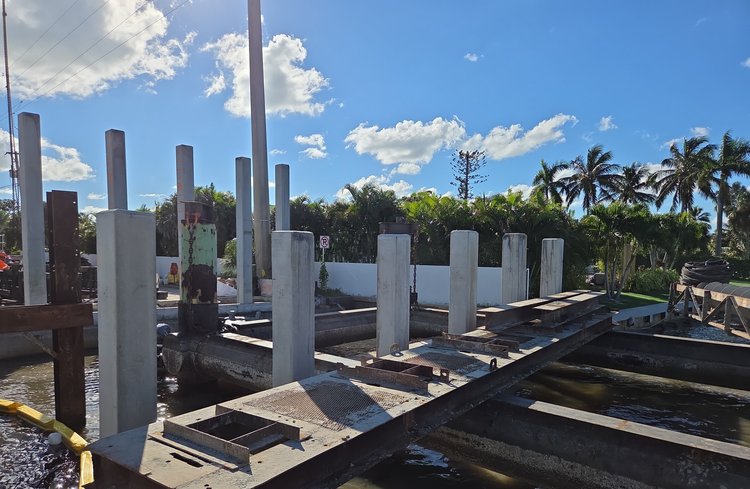

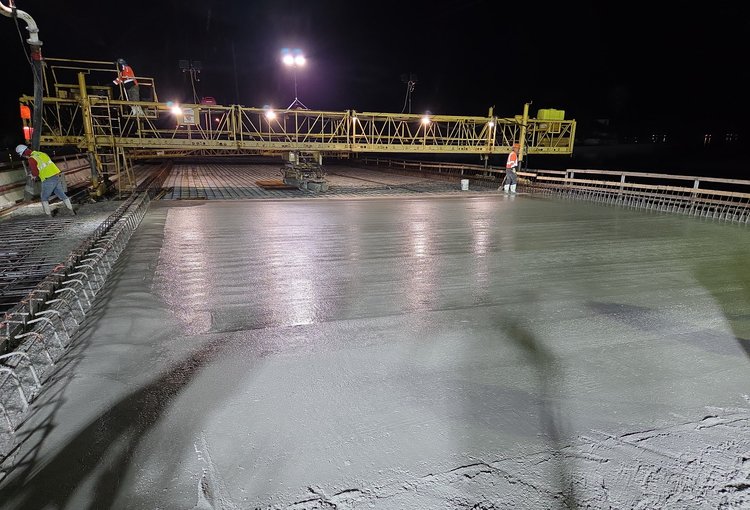

Phase 2 demolition of existing deck span 58, April 2025







Please click on a link below to view construction projects
in other areas of Treasure Coast:
Martin County ProjectsMartin County St. Lucie CountySt. Lucie County Indian River CountyIndian River County

Florida Department of Transportation
Florida Department of Transportation
Florida 511 Travel Info
FDOT District Four Youtube
SunGuide
Kids Zone
zero
