Financial Number: 438379-1-52-01 & 438379-2-52-01

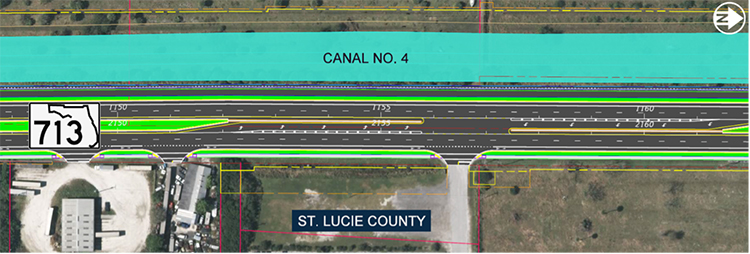

Project Length: 2.610 miles (FPID: 438379-1-52-01: 1.400 miles, FPID: 438379-2-52-01: 1.210 miles)

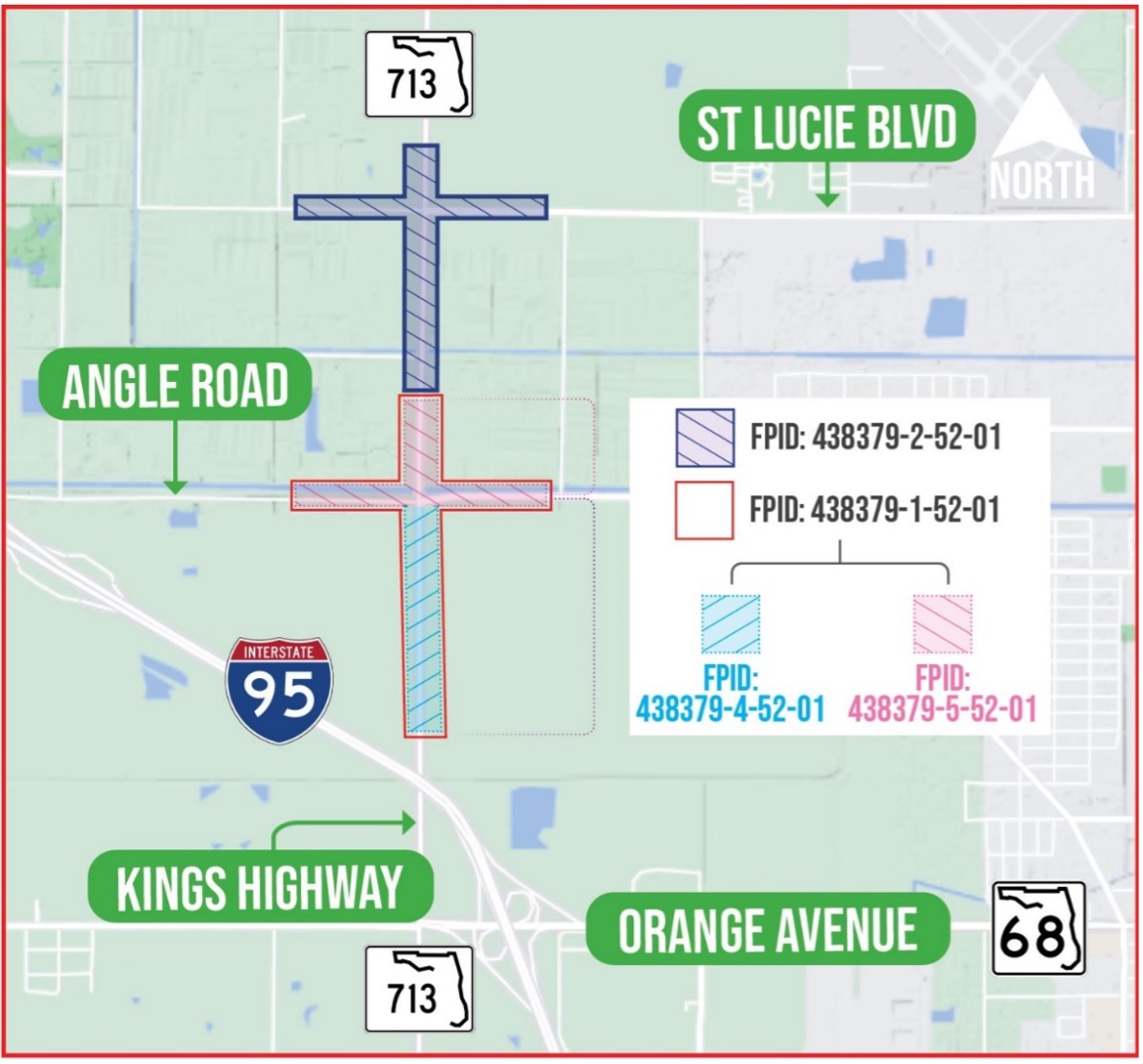

Project Limits: SR 713/Kings Highway from North of I-95 Overpass to North of St. Lucie Boulevard
Virtual Public Workshop: The Public Information Workshop is scheduled for Thursday, February 10, 2022, at 6: 00 pm. The public meeting will be offered in two different formats: virtual and in-person.
FPID: 438379-1-52-01: 438379-1-52-01: SR 713/Kings Hwy from North of I-95 Overpass to North of Commercial Circle
Split into two construction segments
- FPID: 438379-4-52-01: SR 713/Kings Hwy from North of I-95 Overpass to Angle Rd.
- FPID: 438379-5-52-01: SR 713/Kings Hwy from Angle Rd. to North of Commercial Circle
- Projected Letting: July 2026
- Start Date: Fall 2026
- Completion Date: Fall 2030
- Estimated Construction Cost: $61 million
FPID: 438379-2-52-01: : SR 713/Kings Hwy from North of Commercial Circle to North of St. Lucie Boulevard
- Projected Letting: Pending construction funding availability
- Start Date: Pending construction funding availability
- Completion Date: Pending construction funding availability
- Estimated Construction Cost: $43 million
Scope of Work:
- Construction along Kings Highway consists of replacing the existing two lane undivided rural roadway with a newly constructed four-lane suburban divided roadway

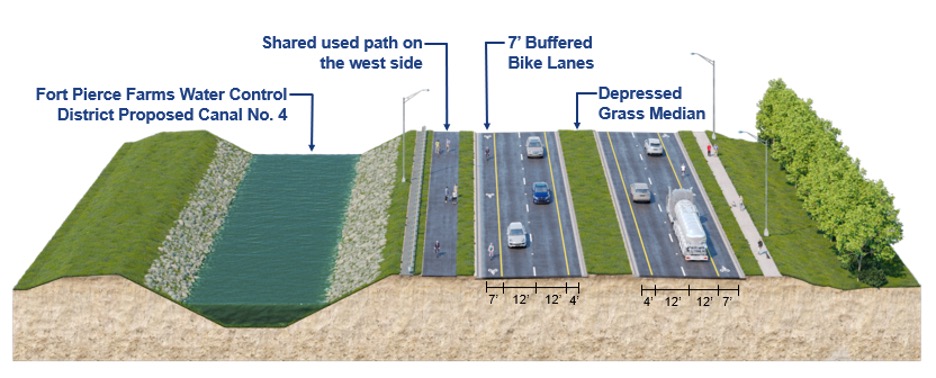

- The proposed roadway will have:
- A 30-foot wide median (22-foot wide raised plus two 4-foot paved shoulders)
- Curb and gutters along the inside and outside
- 7-foot wide outside paved shoulders for use as bike lanes
- 12-foot wide shared use path adjacent to the road along the west side
- 6-Foot wide sidewalk along the east Side
- New lighting System
- New drainage System

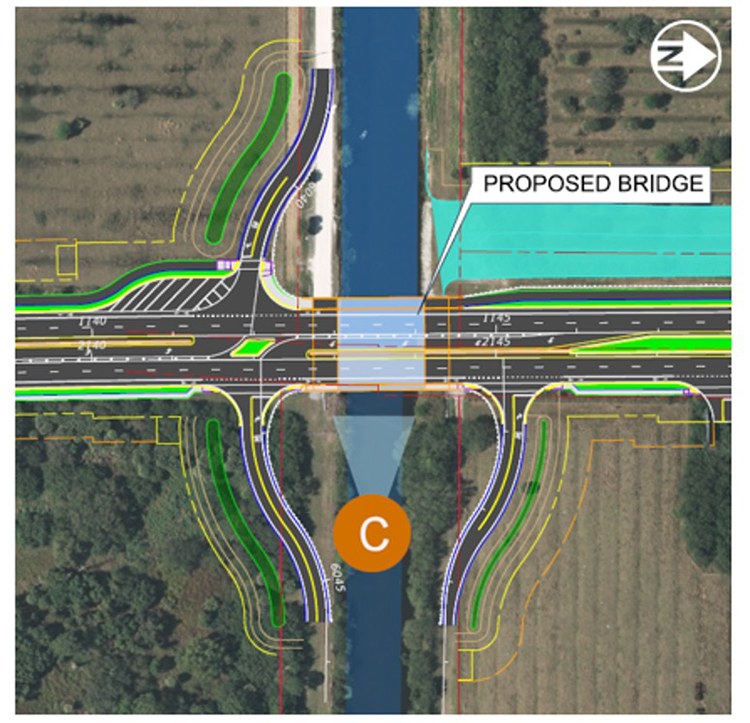

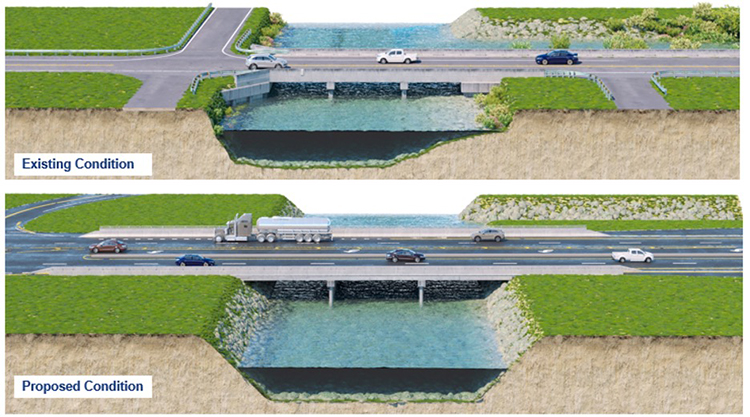

- New flat slab bridges over the C-25 Canal and Canal No.1
- North St. Lucie Water Control District Canal 32E will be shifted to the east
- Fort Pierce Farms Water Control District Canal No. 4 will be shifted to the west

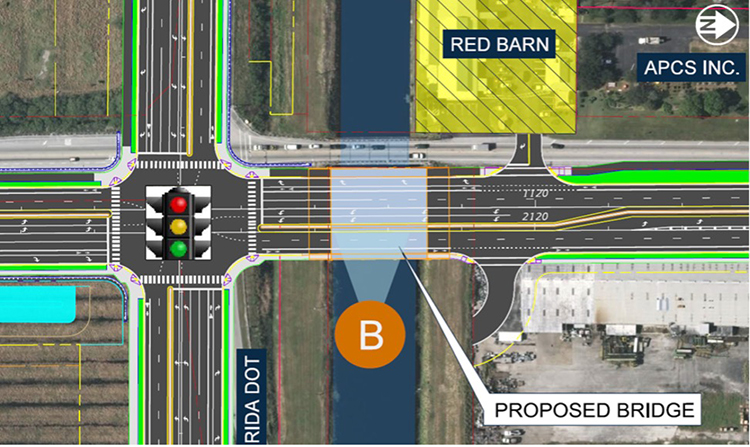

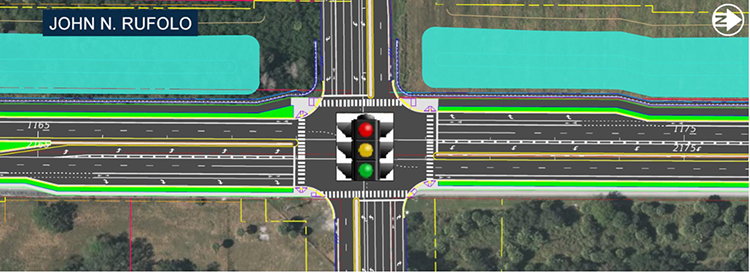

- Intersection Improvements at Angle Road & St. Lucie Boulevard
Construction Impacts:
- Work will done in phases to reduce the effects of construction impacts to the community.
- Temporary off-peak lane closures via flagging operations will be necessary.
- Access to all properties along the project will be maintained.
Contact Information:
